Oct 31, 2019
Trails in Lori Region: trail building and signposting (TECHNICAL REPORT)
Prepared by “Trails for Change” Tourism Infrastructure Development NGO, on October 31, 2019 for HA Foundation.
Technical report is to specify the work done by “Trails for Change” Tourism Infrastructure Development NGO in the period from 14.10.2019 to 28.10.2019 in the frame of the HIKEArmenia and Trails for Change contract (date 01.04.2019). Intended work for this period was: 8.88 km of signposting, trail, blazing of Tumanyan Qarinj Trail, 3 km of trail building, signposting, lopping, brush clearing, blazing of Dsegh Loop Trail, 6.5 km of signposting, blazing of Qarinj Dsegh Trail.
The report will show the completed work.
This technical document comprises the bulk of the report and is accompanied by maps of the proposed route and supporting work pictures.

Total length: 8880 m-signposting trailblazing works.
Status: Completed

Map#1 Tumanyan Qarinj Trail
____ Tumanyan Qarinj Trail

Total length: 6500 m - lopping, trail brushing, signposting, trailblazing.
Status-Completed

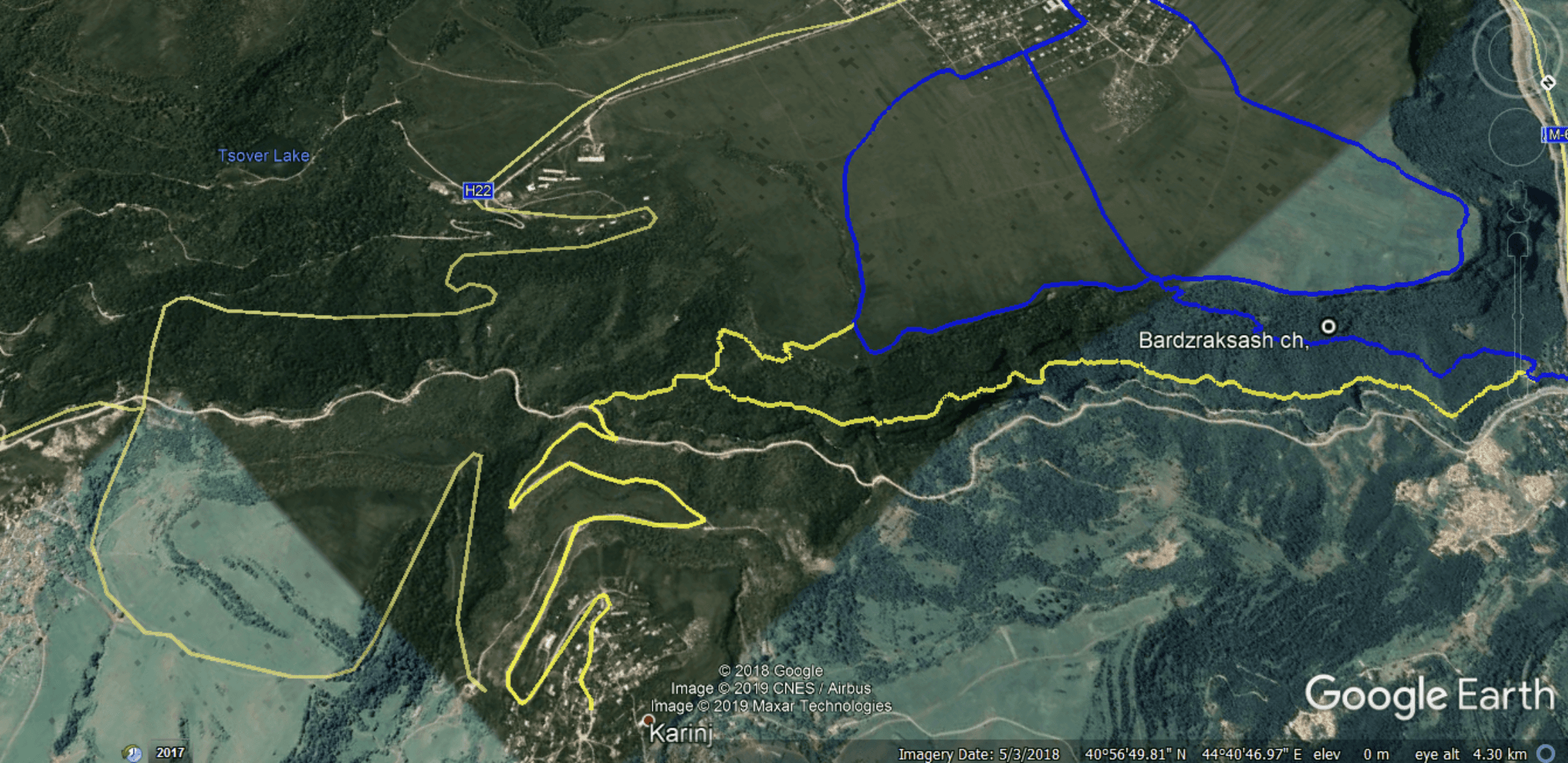

Map #2 Qarinj Dsegh Trail

Table №2

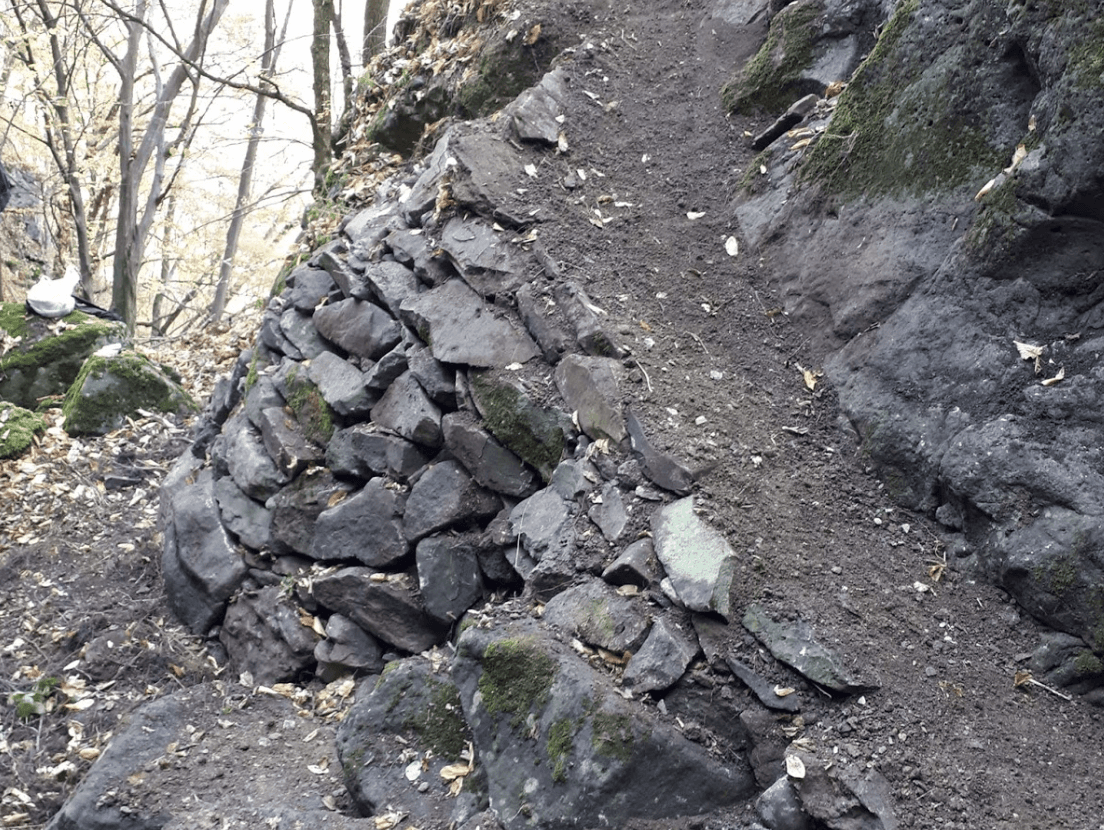

Total length: 3000 m- trail building, signposting, wall building,lopping, trailblazing works.
Status-Completed

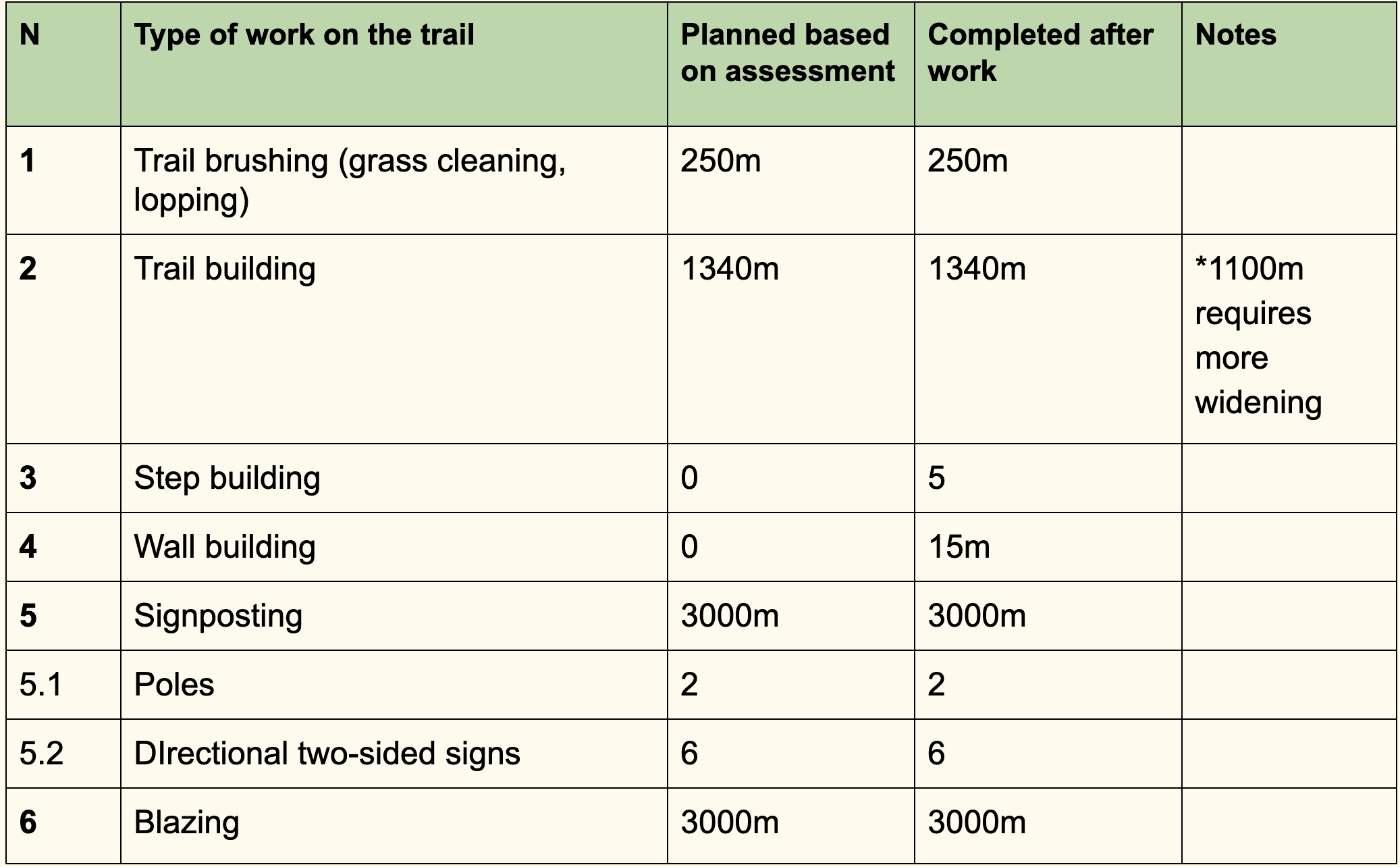

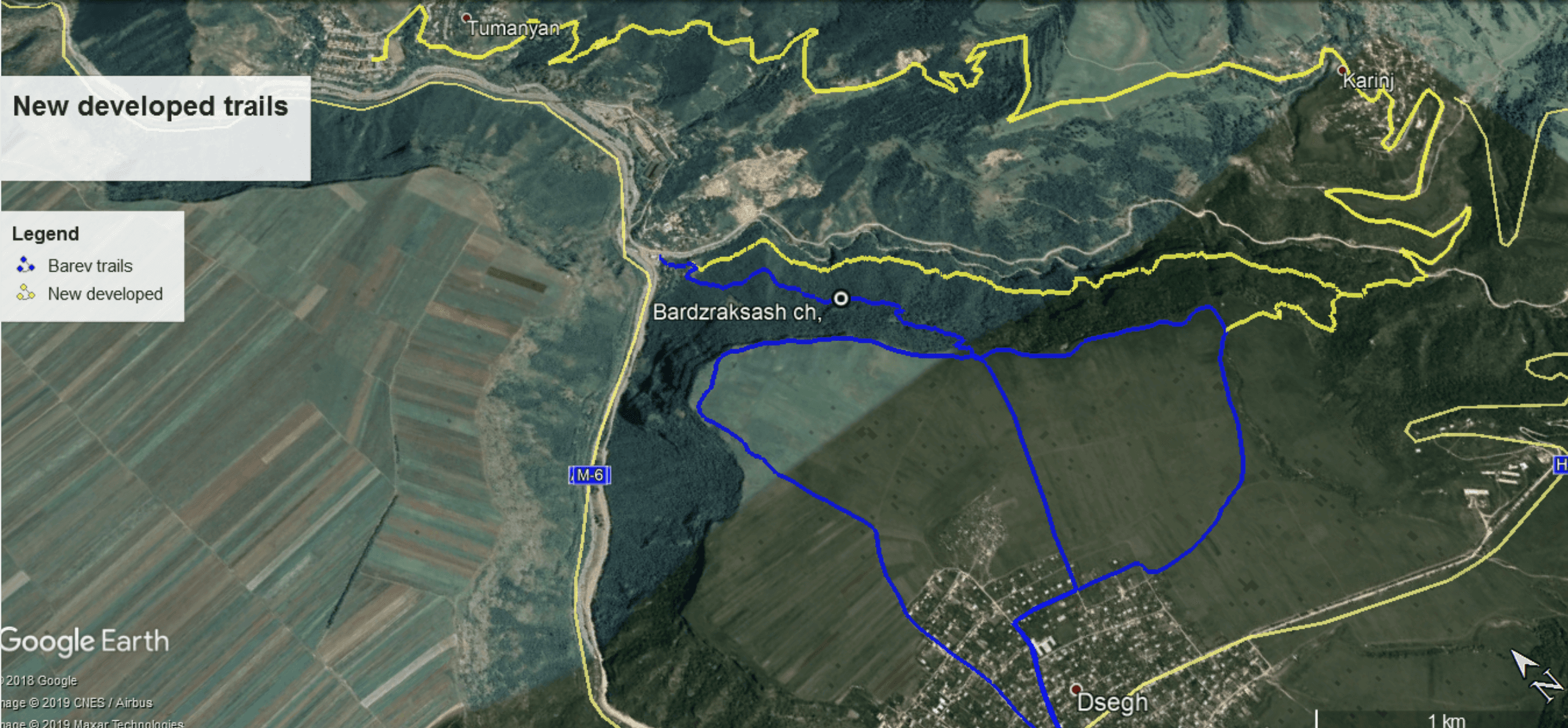

Map# 3 Dsegh Loop

Table №3
The report was prepared by Trails for Change NGO
Anna Tadevosyan: TFC General Manager
Ashot Davtyan: TFC Project Manager
Aida Arakelyan: TFC Project Manager Assistant
Armen Manukyan: TFC Trail Crew Lead
